Set baseline periods, utility rates, and building context for decarbonization planning in EnerG

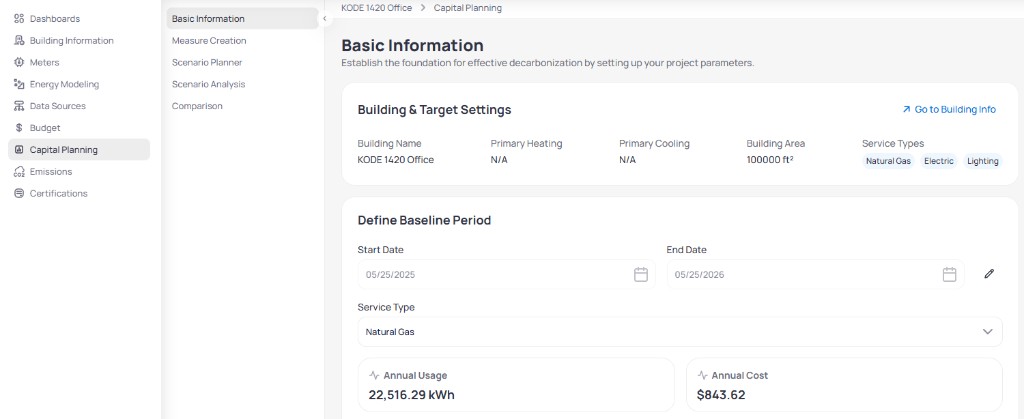

Model energy conservation and projected savings for one building with capital planning. In the building view, click Capital Planning in the left sidebar. Start on Basic Information to set project parameters before you create measures or . For the underlying concepts, see Measures, curves, and scenarios.For portfolio-wide scenario comparison, see Portfolio capital planning.

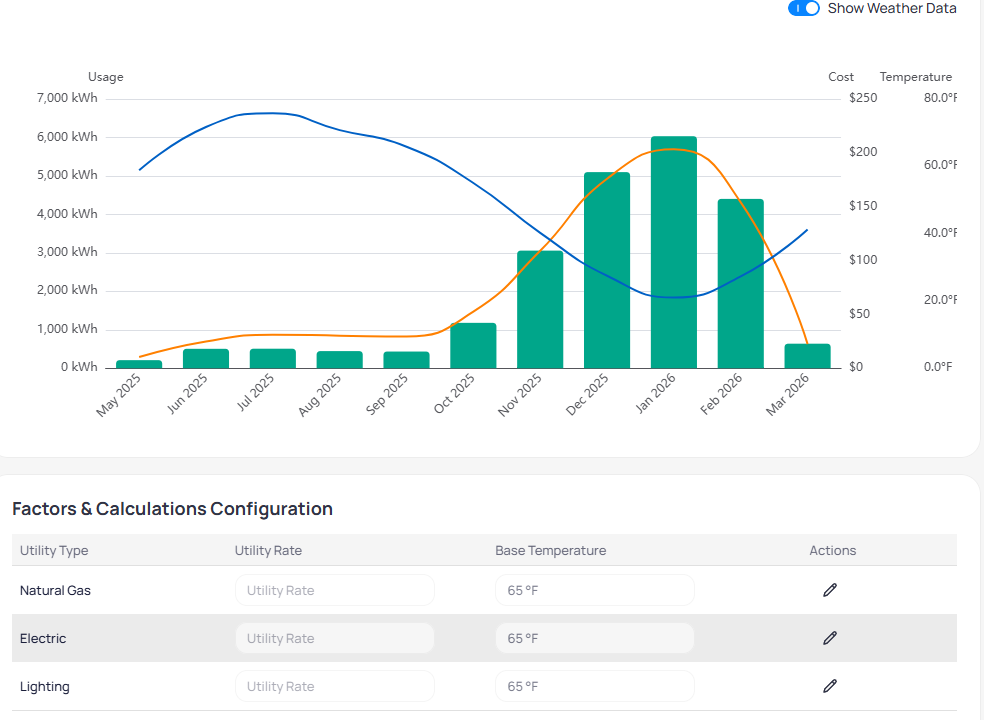

The Factors & Calculations Configuration table sets rates and degree-day base temperatures per utility type. See Weather normalization for degree-day settings.
Column
Purpose
Utility Type
Service category, such as Natural Gas, Electric, or Lighting
Utility Rate
Blended cost per unit for simple cost translation
Base Temperature
Reference temperature for heating and cooling degree-day logic, often 65 °F
Actions
Edit icon to update rate or base temperature
Confirm Utility Rate matches the tariff class or blended average you use in audit narratives and Budget planning rate analysis.
Click + Add new Measure to open the Add New Measure panel.

Add New Measure panel with category, curve, and savings fields
Field
Purpose
Measure Name
Project label shown in the measures table
Primary Category
Grouping such as Lighting Systems or HVAC Systems
Curve
Distribution curve from the table below, such as Flat or Heating
Status
Planning, Implementation, or Operations
Service Types
Fuels affected by the measure
Capital Cost ($)
Upfront project cost
Incentive Amount ($)
Rebates or grants applied to payback
Incentive Source
Program or funder name for audit trails
Click Save to add the row. EnerG calculates payback and fuel-specific savings columns after you save. Additional fields may appear when you select multiple service types.

The Distribution Curves table defines how annual savings spread across months. EnerG provides default cooling, heating, and flat curves derived from degree-day logic on Basic Information.
Column
What it shows
Name
Curve label, such as Cooling (CDD 65°F), Heating (HDD 65°F), or Flat (1/12)
Curves
Curve family: Cooling, Heating, or Flat
Jan – Dec
Monthly factor that sums to the annual savings profile
Assign a curve when you create or edit a measure so EnerG allocates savings without manual spreadsheet work. For when to use each curve type, see Distribution curves.
Select Scenario Planner in the Capital Planning menu to bundle measures into funding packages. Each scenario lists included measures with implementation and operation dates.

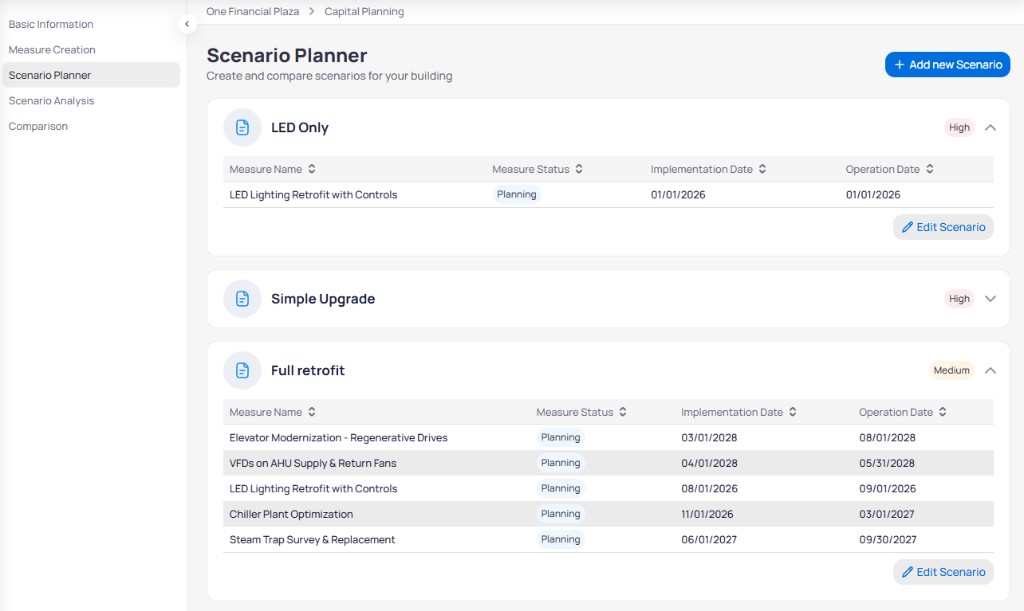

Scenario Planner with expandable scenario cards
Click + Add new Scenario to create a bundle. Expand a card to review measures or click Edit Scenario to change dates and membership.
Click + Add new Scenario to open the Create Scenario panel.

Create Scenario panel with measure selection
Field
Purpose
Scenario Name
Label on the scenario card
Priority
High, Medium, or Low
Select Energy Conservation Measures
Check each measure to include. Tags show the assigned curve, such as Flat (1/12) or Cooling (CDD 65°F)

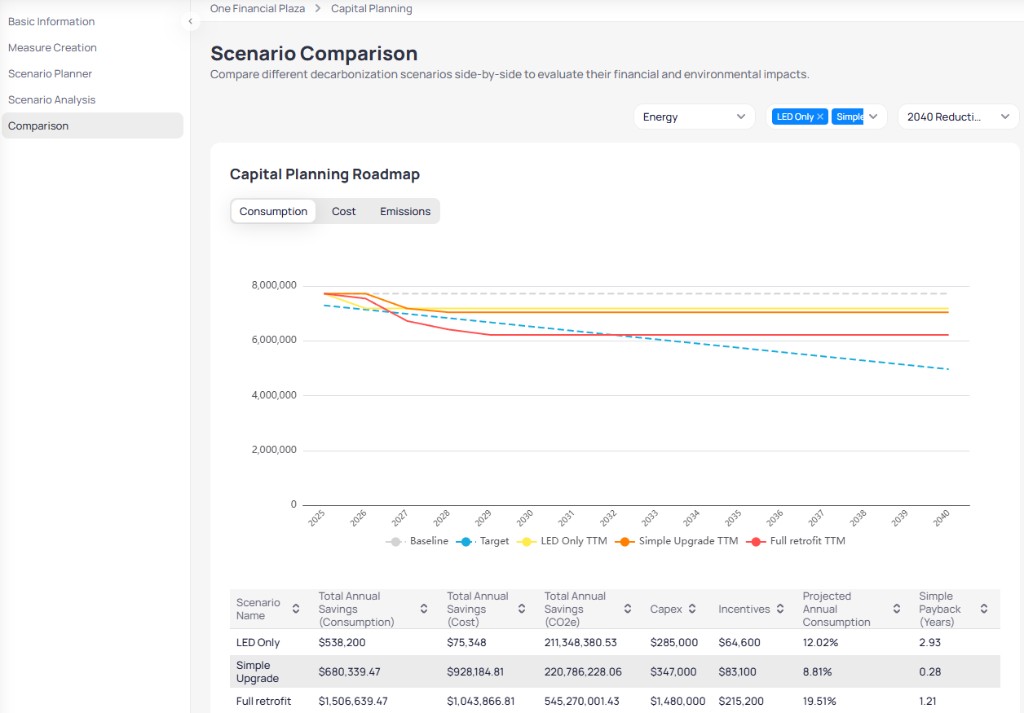

Click Create Scenario, then open Edit Scenario on the card to set Implementation Date and Operation Date per measure when projects phase over time.Review savings and payback on Scenario Analysis. Compare bundles on Comparison or at the portfolio on Portfolio capital planning.
Scroll below the Target chart for service-type breakdowns and a measure schedule.

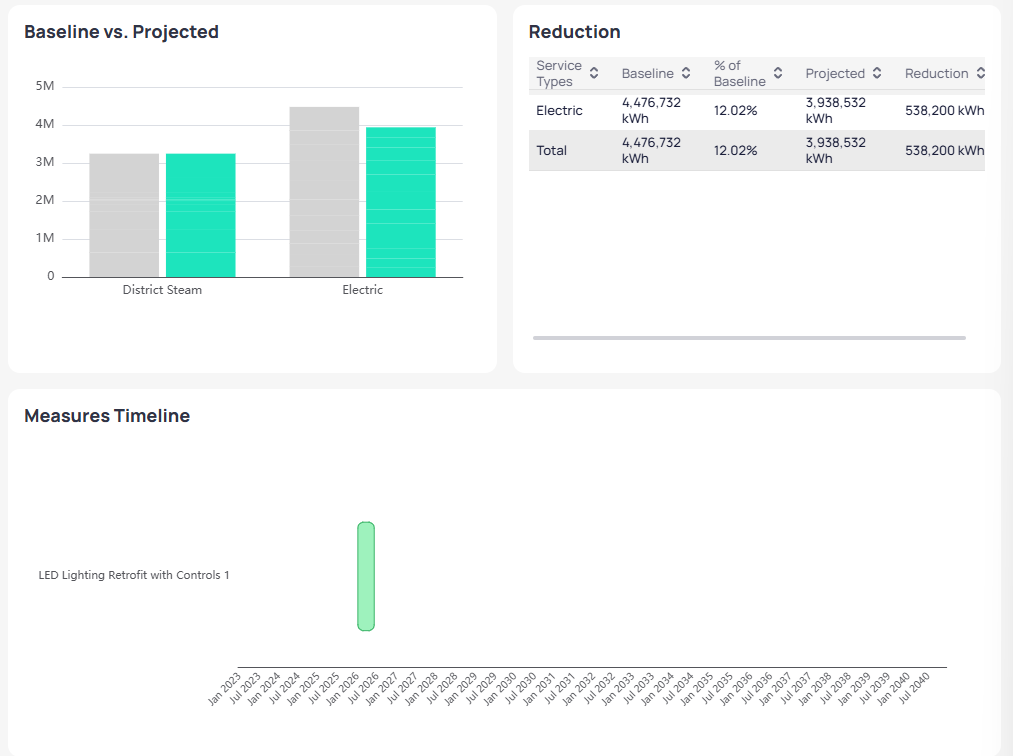

Scenario Analysis Baseline vs Projected chart Reduction table and Measures Timeline
Section
What it shows
Baseline vs. Projected
Grouped bars by service type comparing baseline to projected use
Reduction
Table with Baseline, % of Baseline, Projected, and Reduction per fuel
Measures Timeline
Gantt-style view of when each measure starts savings based on Operation Date

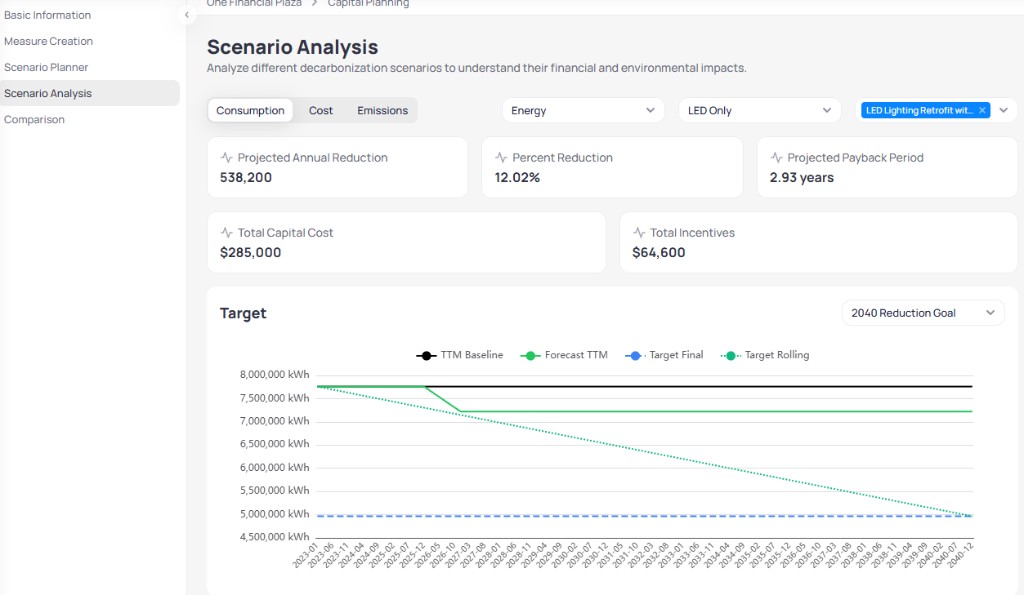

Scenario Analysis shows trailing-twelve-month Forecast TTM and baseline separation for one scenario. Use it when you explain how savings emerge across seasons before you compare bundles on Comparison.
When you stagger implementation dates
Set each measure Implementation Date when work begins and Operation Date when savings start. Staggered dates keep cash flows and contractor access realistic in one scenario.
