FTT from the left sidebar, then select the three-dot menu at the top right and choose Projects.Projects list
The projects list displays all FTT projects with their status, schedule, and configuration details.
The Projects list showing all FTT projects with status, recurrence, and schedule details
Create a project
Select your building

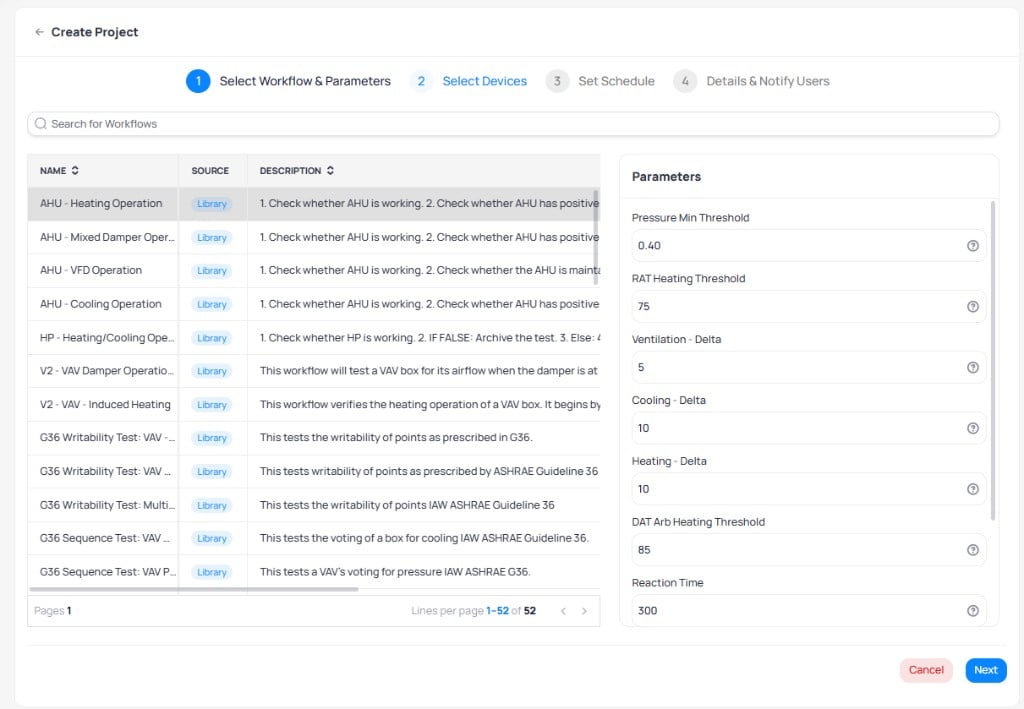

Select a workflow and parameters

Step 1: Select a workflow from the library and adjust its parameters
Select devices

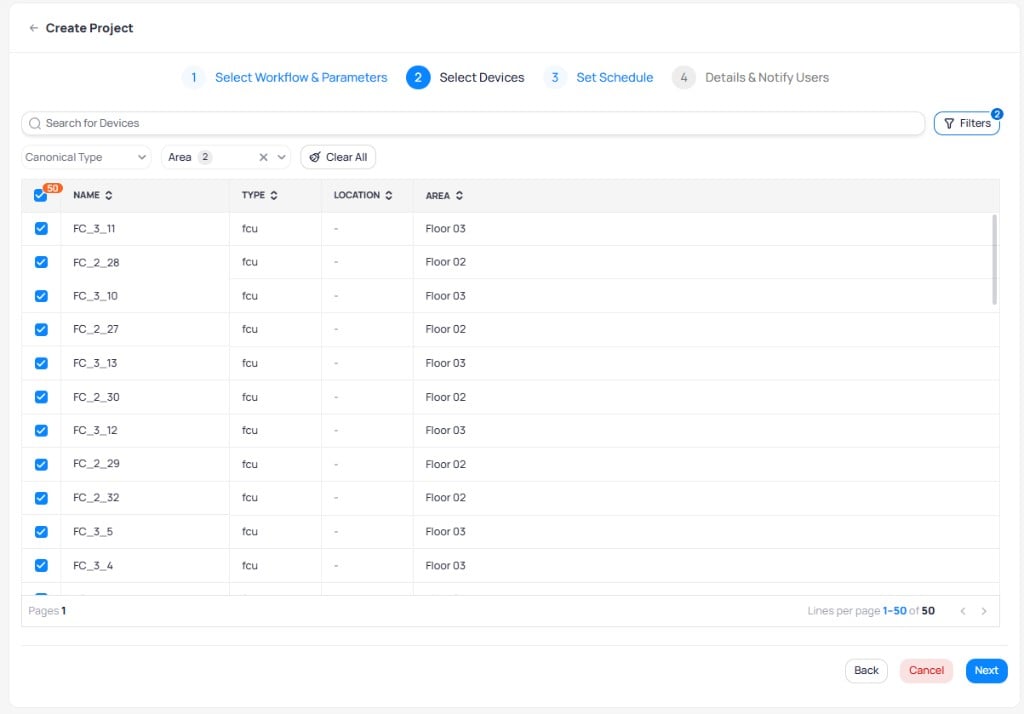

Canonical Type and Area. For building-wide commissioning, select all compatible devices. You can also select specific floors or individual devices.
Step 2: Select devices to include in the project with search and area filtering

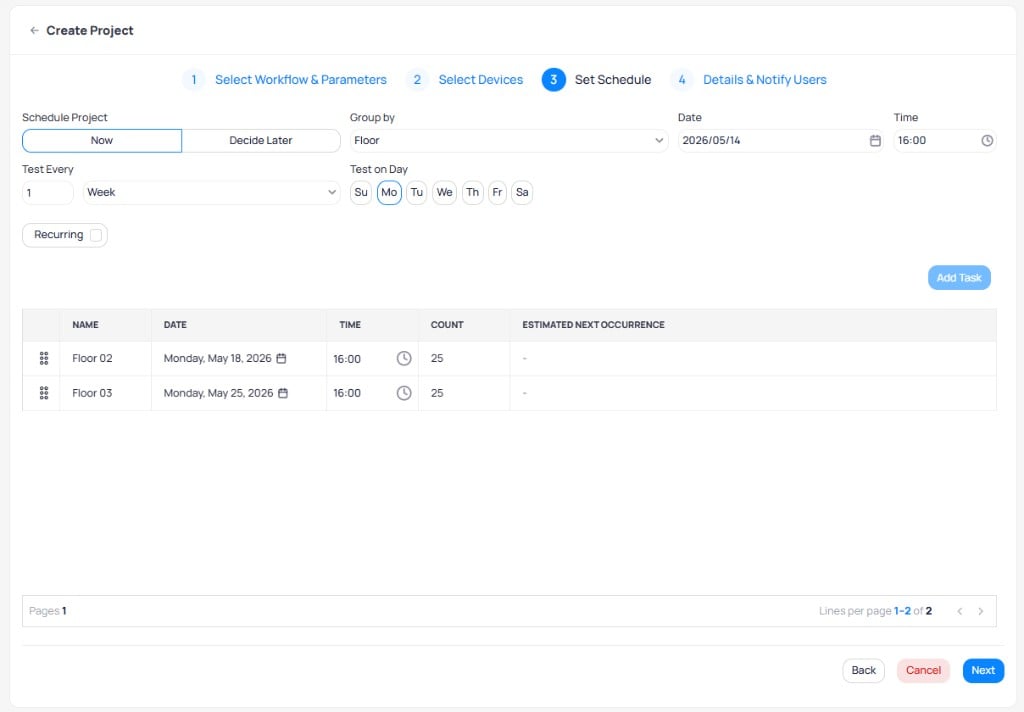

Set the schedule

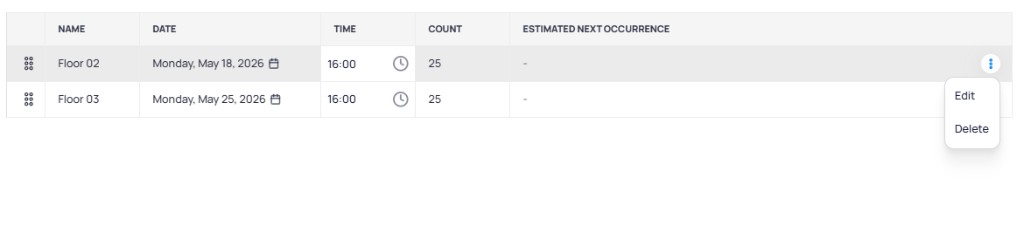

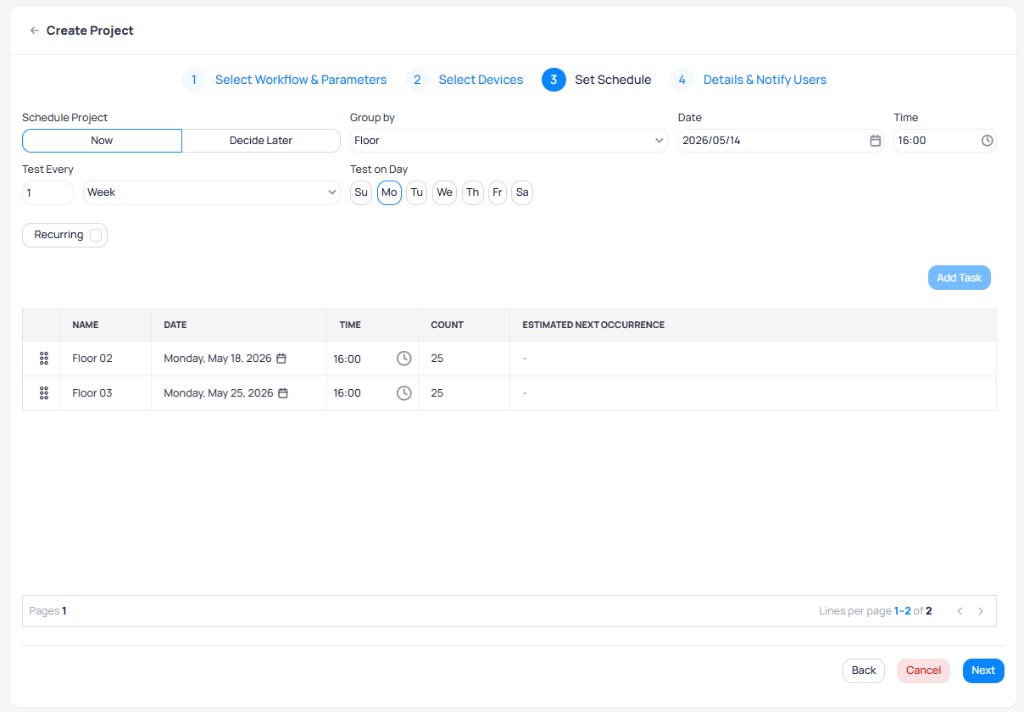

Step 3: Configure the testing schedule with grouping, frequency, and task preview

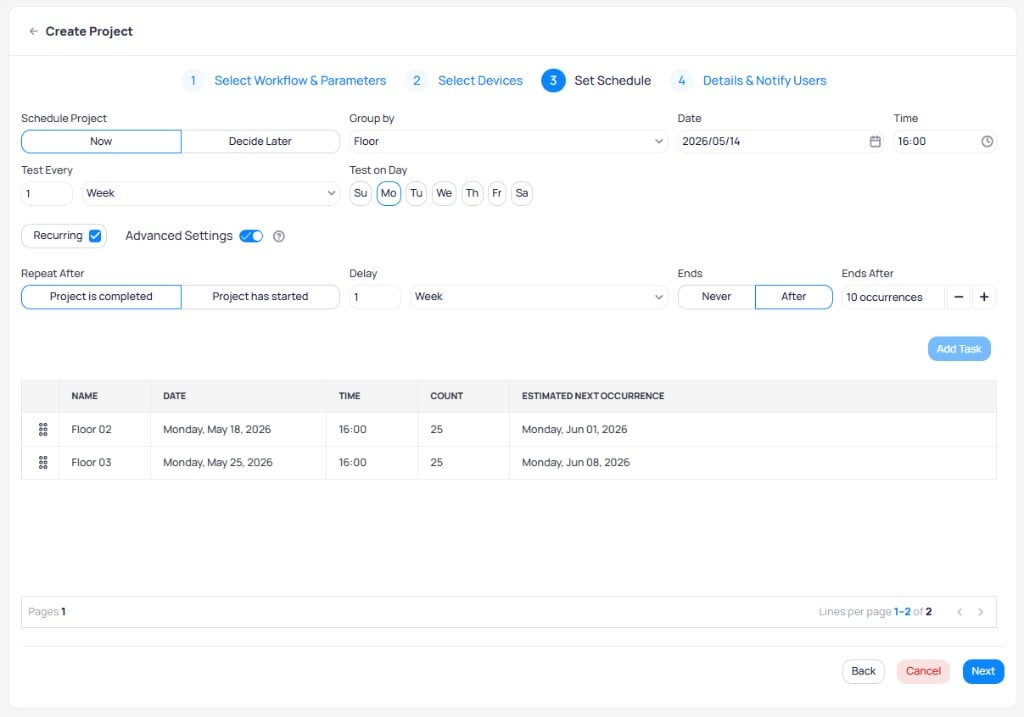

Date is the earliest possible start date. Test on Day (for weekly cadence) is the weekday when runs are allowed. Cloud BMS schedules the first run on the first selected Test-on-Day that falls on or after the Date.For example, if Date is Friday, February 7 and Test on Day is Monday, the project does not run on February 7. It starts on the next Monday after February 7.Test frequencyUse Test Every and Test on Day to define how often tests run. The schedule preview updates as you configure these fields.RecurrenceEnable the Recurring toggle and optionally turn on Advanced Settings to configure repeat behavior.Simple recurrence starts the next cycle after the current cycle finishes. Advanced scheduling starts the next cycle a set time after project start or project end. The platform blocks overlapping advanced schedules.
Advanced recurrence settings with repeat timing, delay, and estimated next occurrences
- Reorder tasks: drag the handle on the left side of each row
- Edit or delete a task: select the three-dot menu on a task row to edit its details or remove it from the schedule
- Add Task: after you remove a device from an existing task,
Add Taskbecomes available. Use it to create a new task for devices that are not in any group, then assign those devices on the Devices tab

Three-dot menu on a task row with Edit and Delete options

- Details: change the task name, start date, start time, notify users, and adjust workflow parameters for this specific task

Edit Task Details tab with task configuration and parameter overrides

- Devices: add or remove individual devices from this task

Edit Task Devices tab showing device selection for a specific task

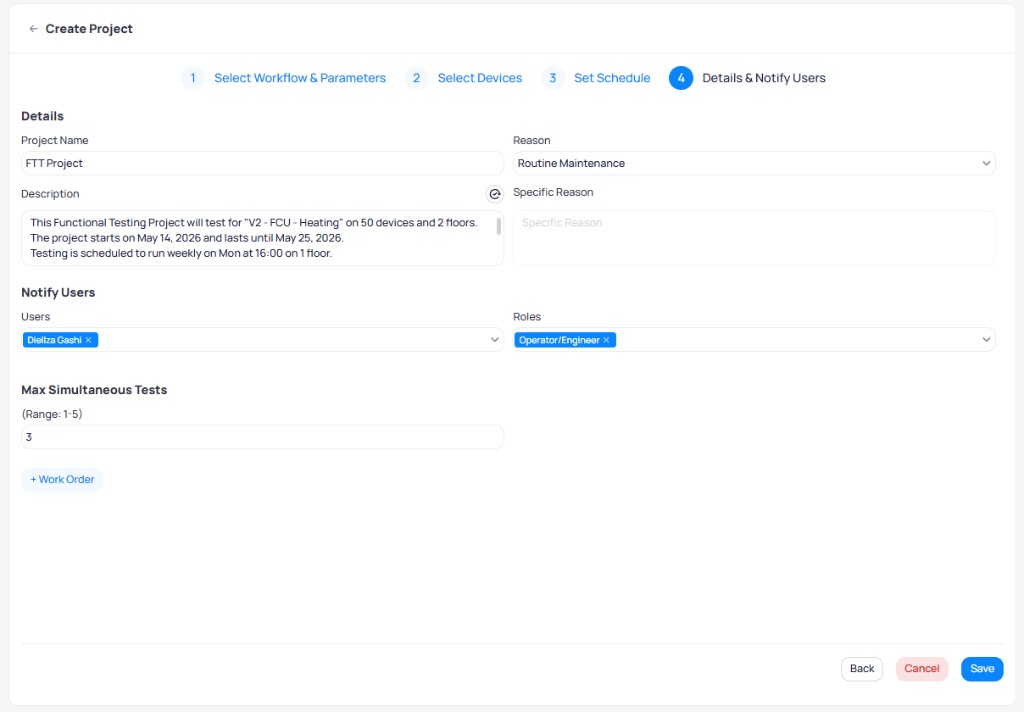

Add details and notify users

Step 4: Configure project details, notifications, and maximum simultaneous tests
Work orders
Select+ Work Order to configure automatic work order creation when testing completes. Work orders push results to an external system through the QR Connect API.

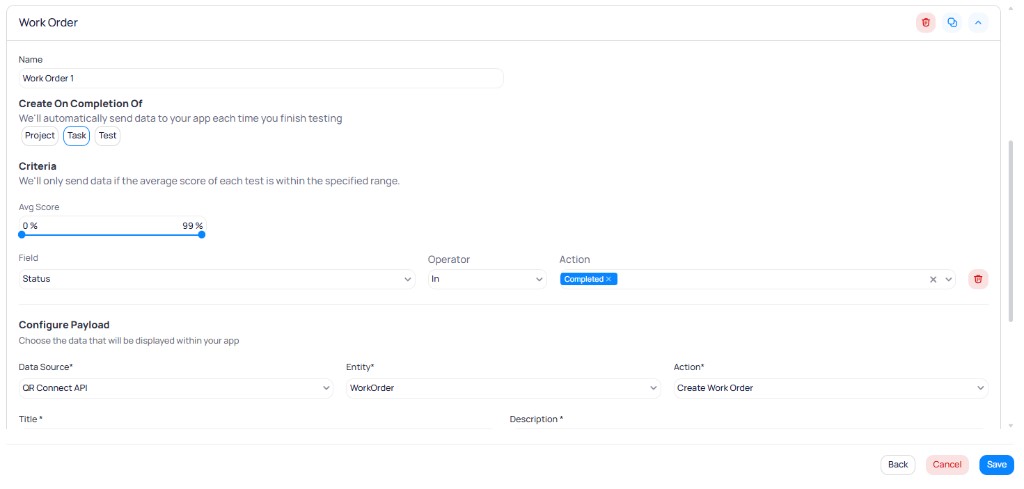

Work Order configuration with trigger, criteria, and payload settings

Payload configuration mapping FTT data to external work order fields
Task Name, Task Score, Workflow, Building, Task Reason, Task - Number of Devices, Task Started At, Task Ended At, Task Readable Duration, Task Duration, Test Status, Device, and Area.Select Save to create the project. A preview of the project and all scheduled dates appears.Manage existing projects

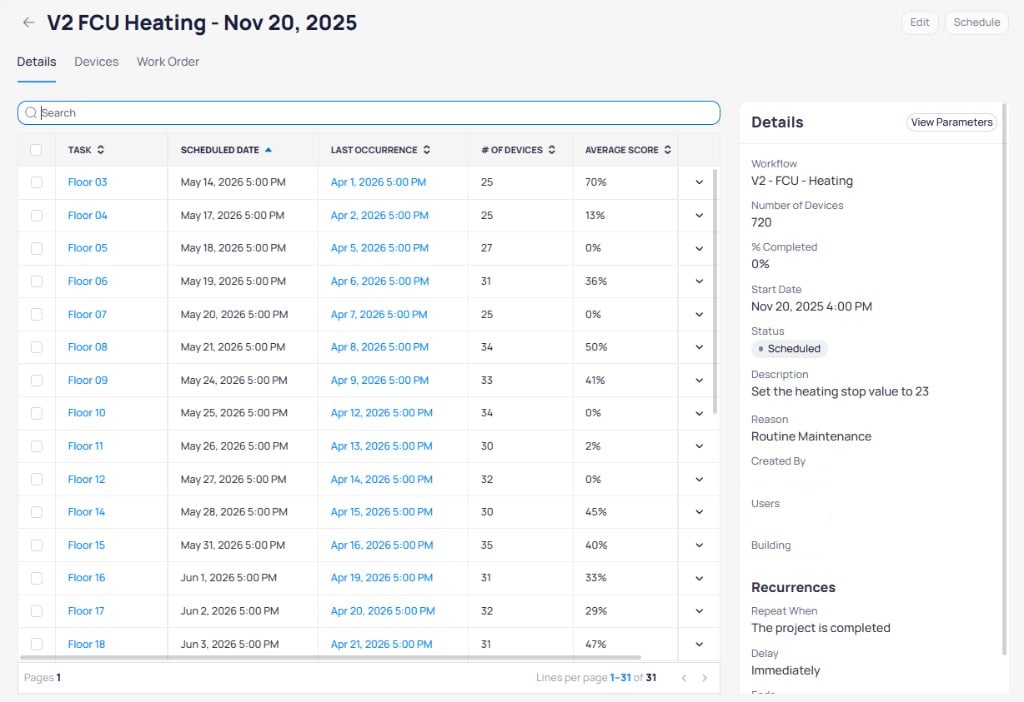

Projects often run over weeks or months. As tasks complete, statuses turn green and average scores update for each task. Select a project from the list to open its details.Project details
The Details tab shows all scheduled tasks with their execution history and scoring. The right panel displays project metadata including workflow, device count, completion percentage, status, description, recurrence settings, and assigned users.

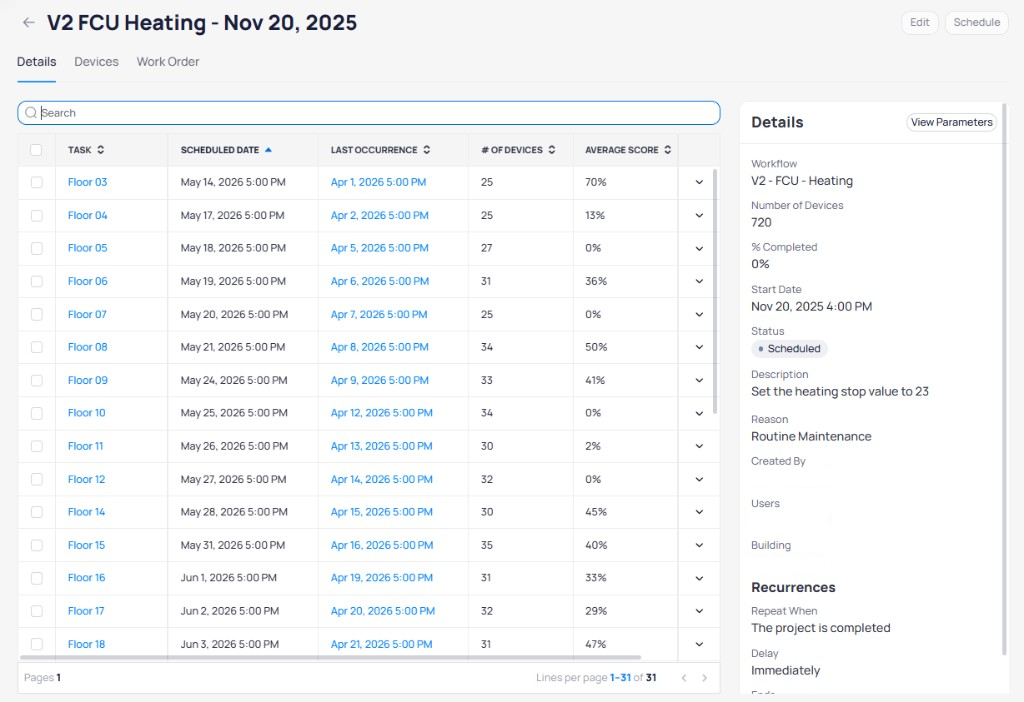

Project details view showing scheduled tasks, scores, and project metadata

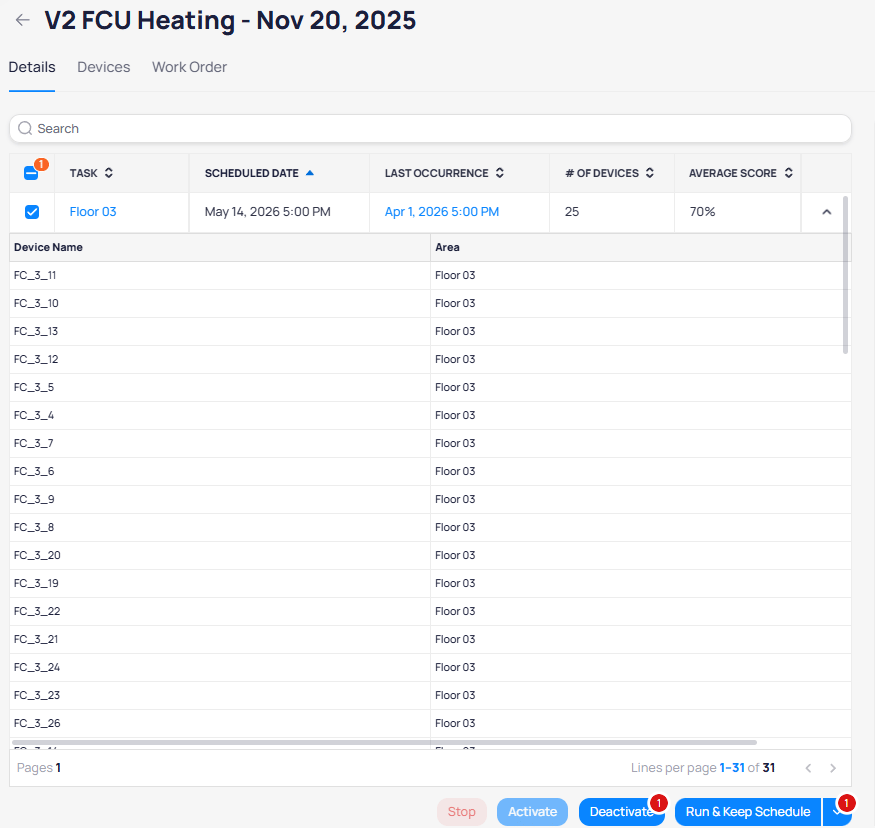

Expanded task showing individual device assignments with action buttons
Devices tab

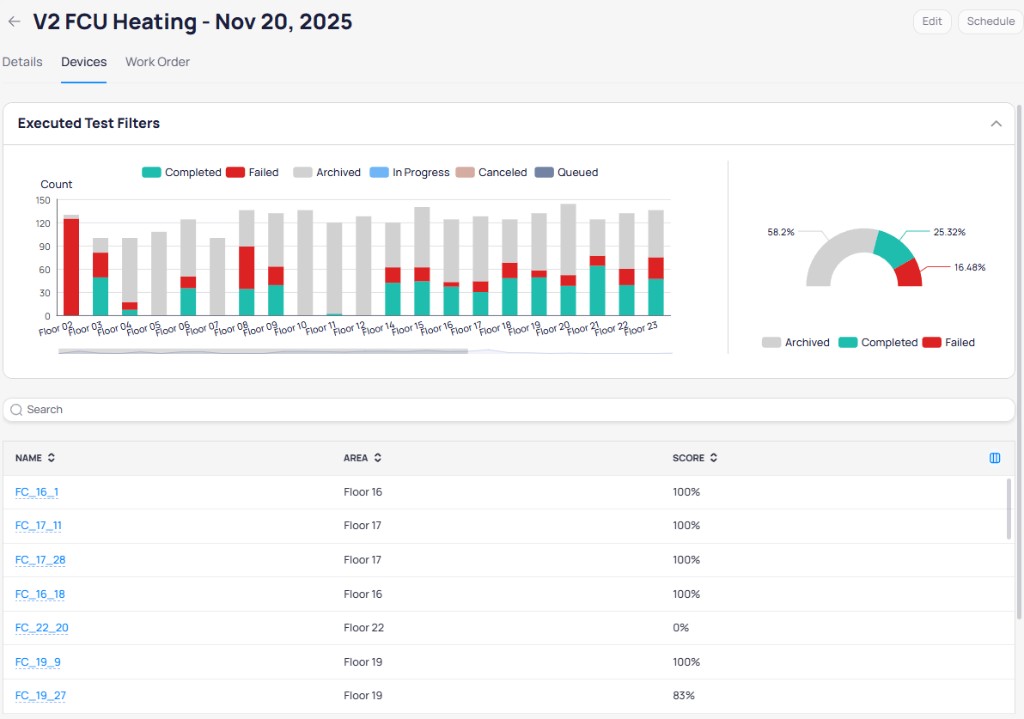

The Devices tab provides a cross-project view of all device test results. A stacked bar chart shows completed, failed, and archived test counts per floor. A donut chart summarizes overall pass rates. The device table lists individual scores and allows sorting and searching.
Devices tab with test result charts and individual device scores
Task actions
Select one or more tasks in a project to access the following actions:Project-level actions
Best practices
Align projects with heating and cooling seasons
Schedule tests during optimal windows
- Weekly cadence: creates a manageable workload for operators to review results
- Late afternoon timing: equipment runs at steady state rather than during startup
- Low-occupancy days: minimizes impact on occupants
